Plan, control and reviews
Plan the work and deliver from the model.
Schedule work on Kanban boards and Gantt charts, track budgets and TPMs, follow an SE process, control changes, take baselines, and assemble review packages, deliverables and slides from the same model.
What you can do

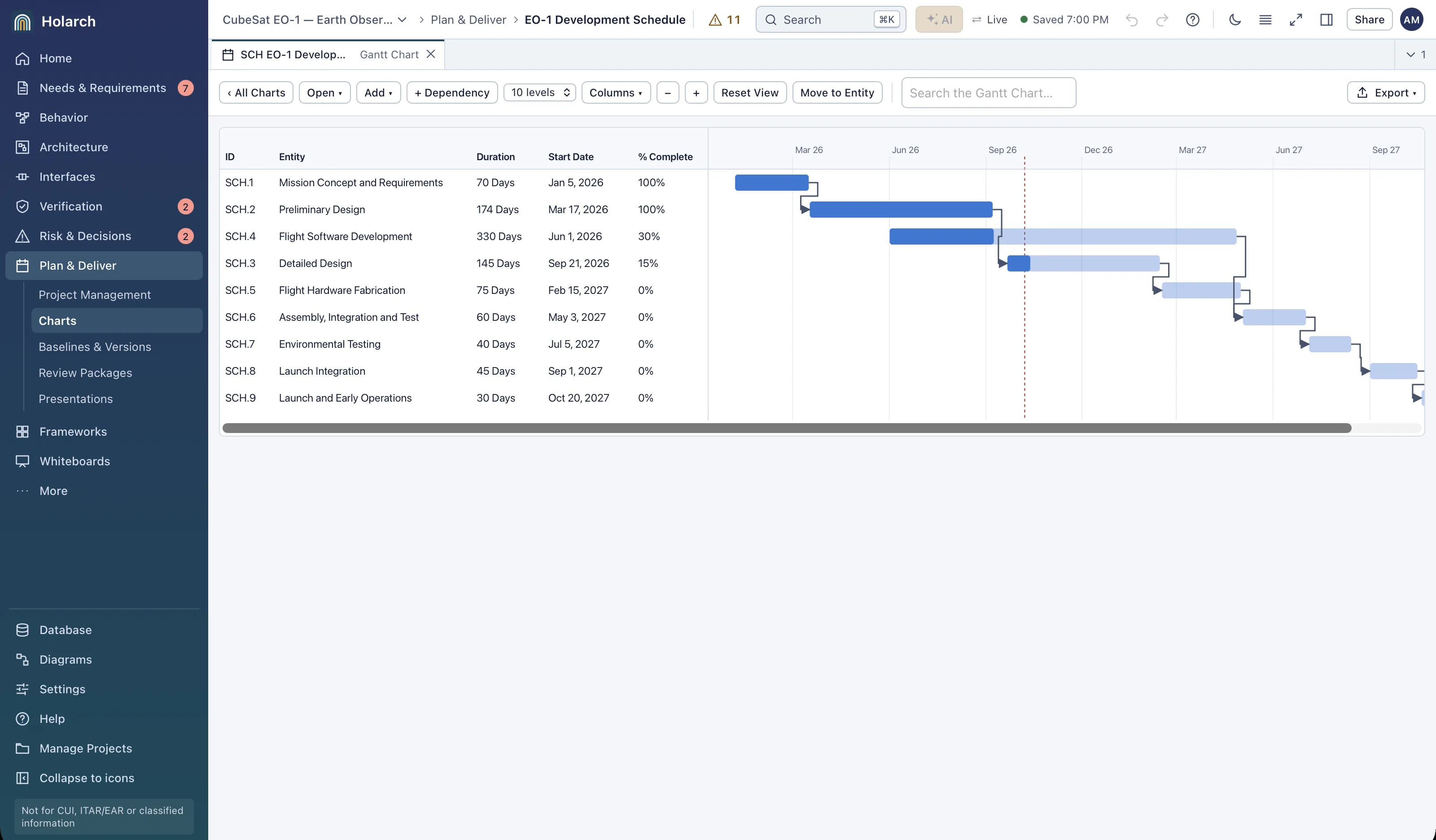

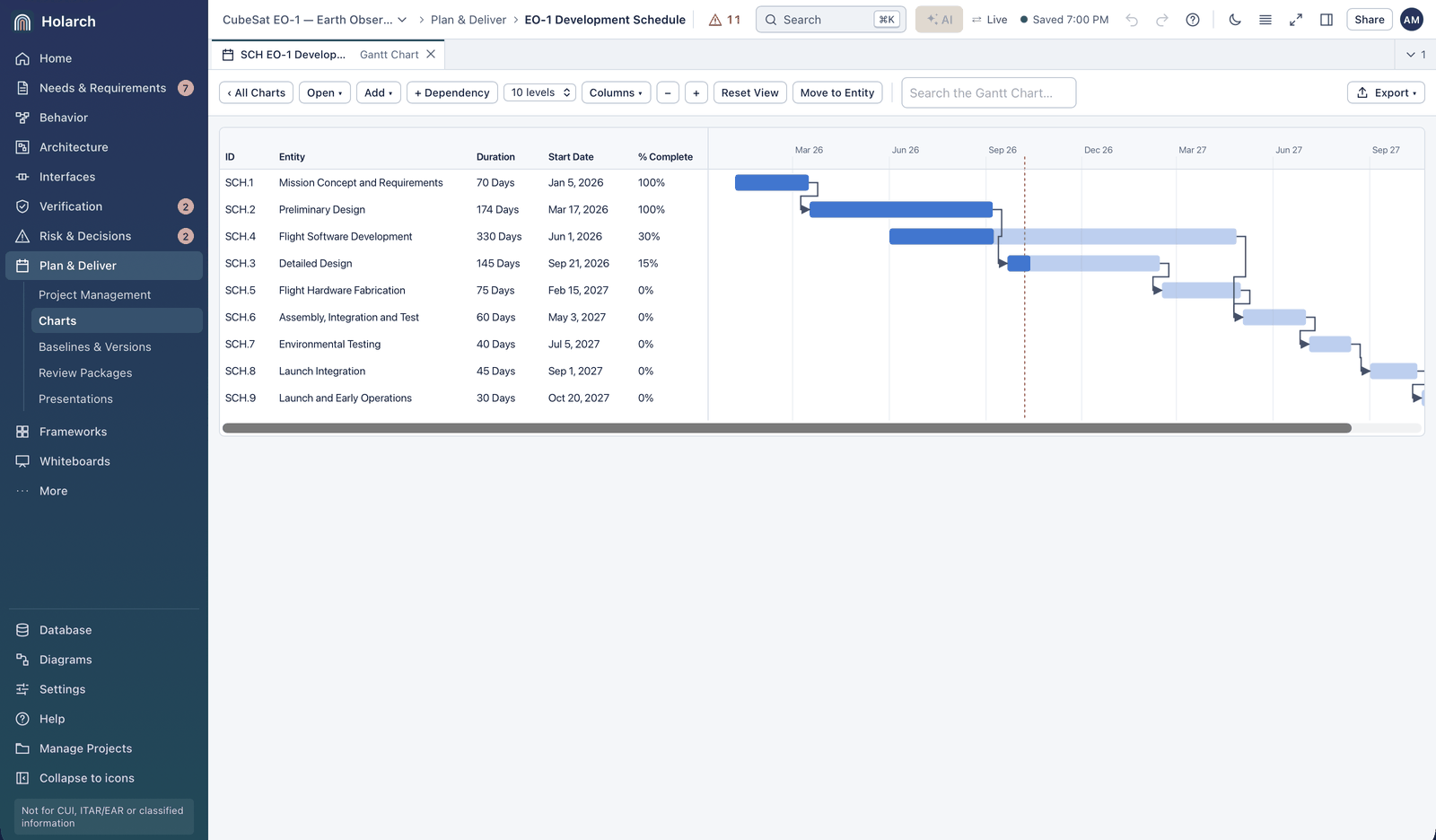

Kanban and Gantt
Kanban boards with columns and tasks, and Gantt charts with dependencies, percent complete and zoom. A calendar and upcoming dates sit beside them.
See the margin on every budget and TPM
Roll mass, power or cost up the system structure with contingency and margins. Track technical performance measures against planned milestones.
See what changed since the baseline
Snapshot the whole project or one document. Compare two baselines, or a baseline with the current model, and export the differences.
Give reviewers one package
Assemble documents and other artifacts into one compilation and export it as a Word document.
Present slides that stay linked to the model
Build slide decks with slides that stay linked to model items. Present in the browser or export PowerPoint, HTML or Word.
Charts
Saved charts such as XY plots and risk burn-downs, plus summary charts on the dashboard. Export PNG, SVG, Word, HTML or CSV.
Change approved items under control
Propose changes to approved or baselined items with a reason, the affected items and staged changes. The model stays as it is until the approvers approve; Apply Changes then applies every change as one undo step. Owners can require change requests for approved requirements and items in the latest baseline. Change Requests.
Follow your SE process phase by phase
SE Process follows the project phase by phase through the process you choose: the Kossiakoff SE method, ISO/IEC/IEEE 15288, the NASA project life cycle, the DoD acquisition life cycle, MIL-STD-499B or the Vee model. Checks are read from the model and link to the page where the work is done. SE Process Guides.
Reuse items from libraries (Team)
Publish a project's items as fixed releases and reuse them in other projects, read-only or as local copies that report what changed in later releases. Libraries.
Link items across projects (Team)
Trace a subsystem requirement or a test to an item in another project. Each person sees the linked item only when they can open its project. Links to other projects.
See what changed and who changed it
Activity lists every recorded edit in the project, newest first, with the value before and after, filtered by date, person, class and kind of change. Activity.
Document markings
A header, footer and first-page notice for the organization, the project or one document: Company Proprietary, Distribution Statements A–F, an export-control notice, a copyright or a contract number. It prints on Word, Excel, diagram and slide exports. Markings are text you choose; Holarch is not approved for classified, CUI or ITAR/EAR data. Document Generation.
Deliver what the review needs
- Baseline the project and each specification with its approvers.
- Insert live diagram pictures and query tables into the review report.
- Export the package as Word; revision history and approvals come from the baselines.
- Add RVTM, ICD and risk register exports from each page.
- Deliverable Setup adds a title page with contract number, CDRL item and DID number, a running header and footer, and signature lines for the planned approvers.
- Redline (DOCX) shows the changes since a baseline as Word tracked changes.
- Start documents from built-in templates such as SyRS, ICD, Test Report and Configuration Management Plan, or from your project’s and organization’s own templates.
How it works
- Plan the work. In Plan → Project Management, create a Kanban board or Gantt chart and add tasks and dependencies.
- Baseline. In Control & Reviews → Baselines & Versions, type a name such as “PDR” and press Enter.
- Write the report. Create a document and insert diagrams and tables from the model.
- Assemble the package. In Control & Reviews → Reviews, click + New Review Package and add each document.
- Build the slides. In Presentations, create a deck, add slides and export it as PowerPoint.
See it in Holarch
