Guide · Requirements
How to write good system requirements: examples and checklist
A good requirement says one thing the system must do or be, in words two engineers read the same way, with a value that a test or an analysis can check. This guide covers needs versus requirements, the parts of a requirement statement, the quality characteristics in ISO/IEC/IEEE 29148 and the INCOSE Guide to Writing Requirements, a checklist with before-and-after examples, verification and acceptance criteria, TBD and TBR values, and requirement types, all worked on one CubeSat specification.
On this page
- Why the wording of a requirement matters
- Stakeholder needs versus requirements
- The anatomy of a requirement
- Quality characteristics of a good requirement
- The checklist: rules with before and after examples
- Write the verification method and acceptance criteria with the requirement
- Handling TBD and TBR values
- Requirement types
- Worked example: reviewing the EO-1 specification
- Common mistakes
- Try it in Holarch
- Download the checklist
- Questions about writing requirements
- Where to go next
Why the wording of a requirement matters
A requirement is a contract between the people who ask for a system and the people who build it. Everything downstream reads it: the designer sizes a component against it, the test engineer writes a pass criterion from it, the change board weighs a change against it, and the customer accepts the system by it. Each of them reads the same sentence, usually without the author in the room. If the sentence can be read two ways, it will be, and the difference surfaces late: at a test that "passes" against a criterion nobody agreed, or at acceptance, when the customer meant something else.
Poor wording also breaks the rest of the model. A requirement without a value cannot be allocated to a component, because nobody can say whether the component meets it. It cannot be verified, so it shows up as a coverage gap in the traceability and the verification matrix. And when it changes, nobody can tell whether the linked design still holds. Writing requirements well is the cheapest quality work in a project: an hour on a sentence at the start saves a test campaign at the end.
The guide uses one running example, EO-1, a fictional 6U CubeSat that images farmland in four spectral bands. Its specification, SRS-001 EO-1 System Requirements Specification, has 32 requirements, most of them sound and three of them weak on purpose. It is the same model as the end-to-end MBSE example project. The stakeholder needs N1 to N3 quoted here are the ones the traceability guide adds to the model.
Stakeholder needs versus requirements
Requirements writing starts one step earlier, with the needs. A stakeholder need is what a user, operator, customer or regulator expects, in their own terms. A requirement is the engineering statement the system is designed and verified against. ISO/IEC/IEEE 15288 keeps the two apart in separate technical processes: stakeholder needs and requirements definition (6.4.2) and system requirements definition (6.4.3). The INCOSE Needs and Requirements Manual makes the same split and treats needs as items in their own right, not as rough drafts of requirements.
| EO-1 example | Checked by | |
|---|---|---|
| Need (N2 Twice-Weekly Revisit) | Farm customers need fresh imagery of their fields at least twice a week in the growing season. | Validation: do customers get what they need from the delivered system? |
| Requirement (1.6 Revisit Time) | The mission shall revisit each target region within 72 hours. | Verification: does the system meet the statement, by test, analysis, inspection or demonstration? |
The difference shows in how each is checked. A requirement is verified: the system is measured against the statement. A need is validated: someone confirms that the system, in its intended use, does what the stakeholder wanted. A system can pass every verification and still fail validation if the requirements missed the point; the verification vs validation guide covers that gap. For writing, the practical consequence is simple: write the need first, then write requirements that would satisfy it if met, and link each requirement back to the need it answers.
The translation is rarely one to one. N2 becomes 1.6 Revisit Time, which is then decomposed into 1.6.1 Ground Track Repeat (3 days) and 1.6.2 Off-Nadir Imaging (25 degrees). Some requirements answer no need directly: 3.1 Orbit Average Power is derived from 1.5 Daily Collection Volume, because the imaging load sets the power the arrays must supply. No customer asked for 30 W, but the imaging they did ask for cannot happen without it.
The anatomy of a requirement
A requirement is more than its sentence. The sentence carries the obligation; a set of attributes around it carries the reasons, the plan for proving it and the bookkeeping. Both halves are part of writing it.
The statement
Most good requirement statements fit one pattern. ISO/IEC/IEEE 29148 (5.2.4) describes it as a subject, an action, an object and constraints on the action, with an optional condition in front; the INCOSE Guide to Writing Requirements recommends the same order and agreed templates for each kind of requirement.
| Part | What it says | EO-1 4.3 Fault Detection |
|---|---|---|
| Condition (optional) | When, in which mode or state, the requirement applies | "…of undervoltage detection" (the triggering event) |
| Subject | The system or element that must comply, named exactly | "The C&DH" |
| Modal verb | The strength of the obligation | "shall" |
| Action | What the subject does or is, as an active verb | "enter" |
| Object | What the action applies to | "safe mode" |
| Performance or constraint | The measurable value, with unit and limit direction | "within 10 seconds" |
Together: "The C&DH shall enter safe mode within 10 seconds of undervoltage detection." The order can move ("When undervoltage is detected, the C&DH shall…" puts the condition first, as in the EARS templates many teams use), but every part should be there or deliberately absent.
Three words carry most of the weight. Shall marks a binding requirement; will states a fact or an intent about something outside the system; should states a goal that is not verified. Whatever convention a project uses, define it once in the specification and keep to it. EO-1 1.1 Reference Orbit ("The mission assumes a 500 km sun-synchronous orbit…") is correctly written as an assumption, not a requirement: it is context for the requirements that depend on it, and the model stores it as a statement that is not scored or verified.
The attributes

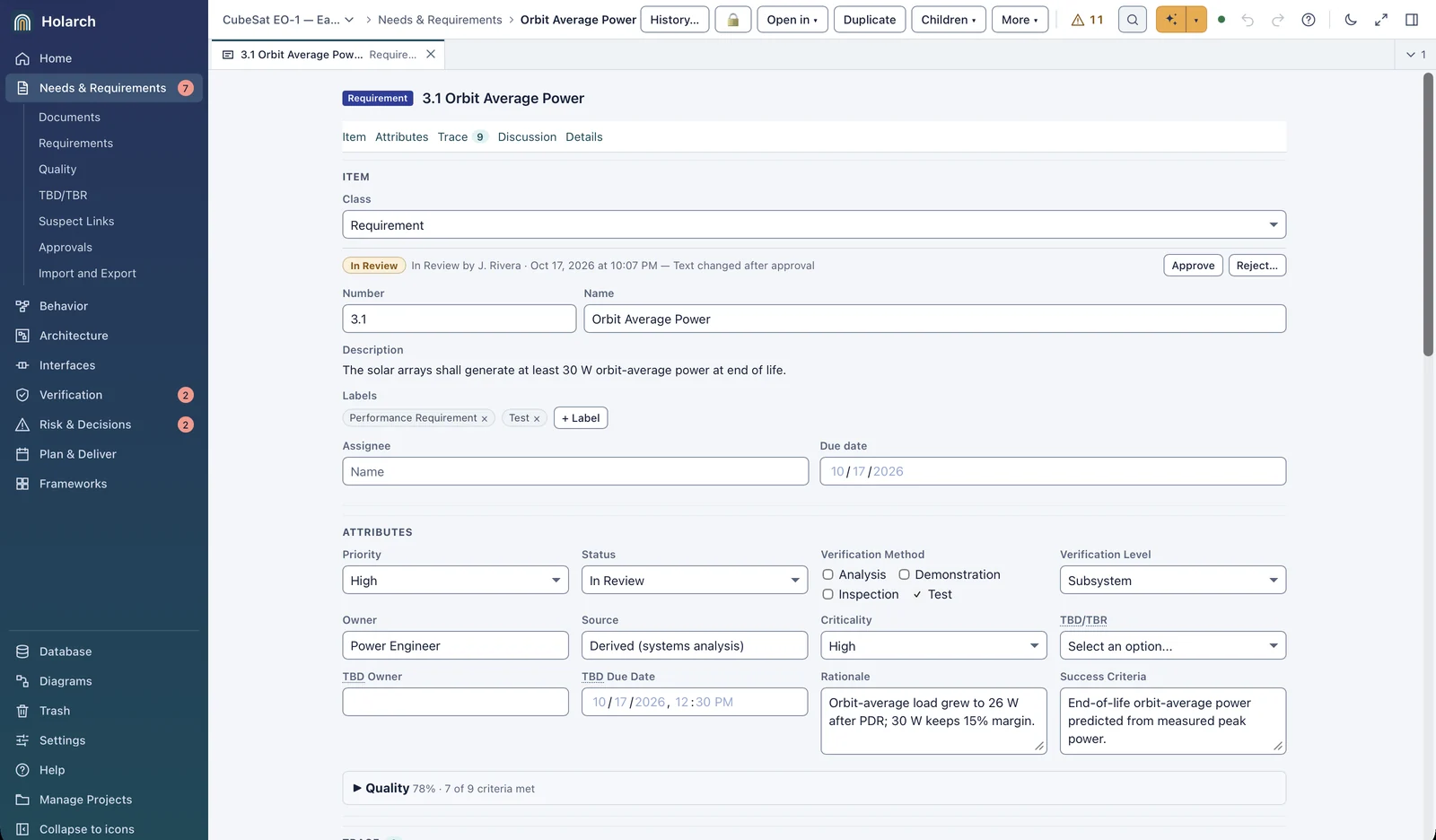

Here is 3.1 Orbit Average Power as the EO-1 model records it, after the post-PDR change from 28 W to 30 W:
| Attribute | 3.1 Orbit Average Power | Why it is there |
|---|---|---|
| Identifier and name | 3.1 Orbit Average Power | A stable handle for links, reviews and change requests |
| Statement | The solar arrays shall generate at least 30 W orbit-average power at end of life. | The obligation itself |
| Rationale | Orbit-average load grew to 26 W after PDR; 30 W keeps 15% margin. | Lets a later reader judge a change without the author |
| Source and parent | Derived (systems analysis); derived from 1.5 Daily Collection Volume | Backward traceability: why the requirement exists |
| Verification method and level | Test, at subsystem level | The plan for proving it, decided while writing |
| Success criteria | End-of-life orbit-average power predicted from measured peak power. | What result counts as met |
| Owner, priority, criticality | Power Engineer; High; High | Who answers for it and how much it matters |
| Status | In Review (it was Approved; its text changed after approval) | Where it is in the agreement process |
| TBD/TBR | None | Whether a value is still open |
ISO/IEC/IEEE 29148 (5.2.8) lists attributes of this kind, and the INCOSE guide adds more; a project picks the ones it will actually maintain. The rationale is the one most often skipped and most often missed later. Without "26 W load, 15% margin", the next person to see 3.1 cannot tell whether 30 W is a hard physical limit, a customer number or a margin choice, and so cannot tell what a change to the load means for it.
Quality characteristics of a good requirement
Style rules are easier to apply when you know what they protect. ISO/IEC/IEEE 29148 (5.2.5) names nine characteristics of an individual requirement, and the INCOSE Guide to Writing Requirements uses the same nine as its C1 to C9, each with a short definition and the rules that support it. The table puts each one as a question a reviewer can ask.
| Characteristic | Question to ask | EO-1 example |
|---|---|---|
| Necessary | If it were deleted, would something the stakeholders need be lost? Is it not a duplicate? | 3.1 is necessary: without it nothing sizes the arrays for the imaging load. |
| Appropriate | Is it written at the right level, without fixing a design choice the level below should make? | 3.1 sets a power level for the arrays, not a cell type or panel count. |
| Unambiguous | Can it be read only one way? | 6.4 "user friendly" fails: two reviewers will disagree on whether it is met. |
| Complete | Does it say everything needed, with no missing condition or value? | 3.5 "warm enough (TBD)" fails: the value is missing. |
| Singular | Does it state one obligation? | 2.5 fails: it asks to recover and to resume imaging, joined by "and". |
| Feasible | Can it be met within the known constraints of technology, cost and schedule? | 3.1 at 30 W is in question: the arrays as designed give about 28 W orbit average. |
| Verifiable | Can a test, analysis, inspection or demonstration show it is met? | 2.5 "quickly" fails; "within 6 hours" passes. |
| Correct | Does it state the real need of its source, with the right value? | 1.2 4.5 m ground sample distance correctly expresses N3 field-level maps, with margin. |
| Conforming | Does it follow the project's agreed templates and vocabulary? | Each EO-1 requirement uses "shall", a named subject and SI units. |
A requirement set has characteristics of its own that no single statement can show. ISO/IEC/IEEE 29148 (5.2.6) lists the set as complete, consistent, feasible as a whole, comprehensible and able to be validated; the INCOSE guide adds correct as C15 and numbers the set characteristics C10 to C15.
- Complete: the set covers the needs. EO-1 states what happens on an undervoltage (4.3) but its only safe mode recovery requirement is 2.5, which is unverifiable as written, so recovery is effectively unspecified.
- Consistent: no two requirements conflict, and terms and units are used the same way. 1.5 asks for 3.2 GB of image data per day and 5.4 for 3 GB received on the ground; they agree only because 5.4's rationale says "after compression". Without the rationale they look like a conflict.
- Feasible: the requirements can be met together. Each power requirement may be feasible alone, while 30 W orbit average, the array area and the mass budget together may not be.
- Comprehensible: a reader can tell what is expected of the system and how the requirements relate, which depends on structure, numbering and traceability as much as on wording.
- Able to be validated: the set can be shown to lead to a system that meets the needs, which is why each top-level requirement links back to a need.
The checklist: rules with before and after examples
The characteristics become usable through concrete writing rules. The INCOSE Guide to Writing Requirements numbers them (R1, R2 and so on); the NASA Systems Engineering Handbook (Appendix C) has a shorter checklist on the same lines. The table collects the rules that catch most problems in practice, with an example from the EO-1 specification for each. "Before" is the text as it stands in the demo; "After" is a rewrite. Values marked illustrative show the form, not results of EO-1 analyses.
| Rule | Question to ask | Before (EO-1) | After |
|---|---|---|---|
| One obligation per statement | Exactly one "shall", no "and", "or", "and/or" joining two demands? | 2.5: "The spacecraft should recover from safe mode quickly and resume imaging as appropriate" | "The spacecraft shall resume imaging within 6 hours of a safe mode entry." Further recovery steps that matter get their own requirements. |
| Mandatory wording | "Shall" for a binding requirement, not "should", "will" or "may"? | 2.5: "should recover" | "shall resume" |
| Measurable value with a unit | Does every performance word have a number and a unit? | 2.5: "quickly" | "within 6 hours of a safe mode entry" |
| Limit direction stated | Is it clear whether the value is a minimum or a maximum? | 1.6.2: "image targets up to 25 degrees off nadir" | "image targets at off-nadir angles from 0 to 25 degrees" (a capability range, not a cap on pointing) |
| No escape clauses | Is anything left to the supplier's judgement ("as appropriate", "if possible", "where practical")? | 2.5: "as appropriate" | Removed; the condition that matters is stated |
| No vague or subjective terms | Could two reviewers disagree on whether it is met ("user friendly", "easy", "adequate", "enough")? | 6.4: "The operator interface shall be user friendly and/or easy to use." | "The operator interface shall let a trained operator book a ground station contact in no more than 5 minutes." (illustrative; one requirement per task that matters) |
| Explicit nouns, no pronouns | Does every "it", "its" or "this" have exactly one possible referent? | 1.6.1: "The reference orbit shall repeat its ground track every 3 days." | "The reference orbit shall repeat the ground track every 3 days." The pronoun is harmless here, but in a longer sentence it is the first thing to drift. |
| Conditions stated | Does it say when the value applies: life stage, mode, environment? | "The solar arrays shall generate 30 W." | "…at least 30 W orbit-average power at end of life." |
| Settled values, or tracked TBDs | Is every open value tracked with an owner and a due date, not just written into the text? | 3.5: "The thermal design shall keep the battery warm enough (TBD)." | "The thermal design shall keep the battery cell temperature at or above 0 °C while charging." (illustrative; until the thermal analysis sets it, the TBD attribute names the Thermal Engineer and a due date) |
| No reasons or notes in the statement | Are purpose phrases ("so that", "in order to") and bracketed notes moved to the rationale? | 3.5: "(TBD)" | Statement without brackets; reason in Rationale |
| What, not how | Does it state the need instead of imposing a solution the level below should choose? | "The thermal design shall keep the battery warm by means of a 2 W film heater." (illustrative) | The 3.5 rewrite above: a temperature limit, with the heater left to the thermal design |
| Positive and achievable | Does it avoid "not", "never", "always", "100%" where a measurable limit is meant? | "The C&DH shall never lose a stored command." (illustrative) | "The C&DH shall execute each stored command within 1 second of the scheduled time." (4.2 as written) |
| Rationale recorded | Does it say why the value was chosen? | 3.1 without a rationale | Rationale: "Orbit-average load grew to 26 W after PDR; 30 W keeps 15% margin." |
| Verification method and criteria | Is the method chosen and the pass criterion derived from the statement? | 3.1: method Test; TC-06 expects peak power ≥ 72 W | Pass criterion derived through the power budget: about 80.6 W peak for 30 W orbit average (see the next section) |
| Traceable upward | Linked to a need, a parent or a source requirement? | 3.1 with no upstream link | 3.1 derived from 1.5 Daily Collection Volume |
| Unique | Does any other requirement say the same thing in other words? | A second "The battery shall store 77 Wh" under the thermal section (illustrative) | One requirement, 3.2 Battery Capacity, referenced where needed |
A checklist is a reviewer's tool, not a writing template. Read each requirement once against the whole list rather than hunting for one rule at a time, and record the finding with the rule it breaks, so the author knows what to change. Rules also have false positives. A word-list check flags "every" in 1.6.1 as a universal qualifier, but "every 3 days" is a period, not a claim about all cases; a reviewer decides.
Write the verification method and acceptance criteria with the requirement
The verifiable characteristic is easiest to check at the moment the requirement is written: if the author cannot say how it would be shown to be met, it is not finished. Record two things with each requirement.
- Verification method: test, analysis, inspection or demonstration, and the level of assembly at which it is done (component, subsystem, system). EO-1 has all four: 3.1 is verified by test, 1.5 Daily Collection Volume by analysis, 3.4 Bus Regulation by inspection and 6.1 Contact Scheduling by demonstration. The RVTM guide explains how to choose among them.
- Success criteria (acceptance criteria): the observable result that counts as met, stated so that the test or analysis can be written from it. For 3.2 Battery Capacity: "Measured capacity of at least 77 Wh at C/2 and 20 °C." For 6.2 Image Delivery: "Products on the portal within 6 h for 95% of passes in rehearsal."
Writing the criteria next to the statement catches a class of error that is otherwise found only at the end. EO-1's 3.1 is verified by TC-06 Solar Array Power Test, which measures peak power on a solar simulator and passes at 72 W or more. The requirement, though, is about orbit-average power, and the model converts one into the other with the sunlit fraction (0.62) and the power path efficiency (0.6). A 72 W peak gives 72 × 0.62 × 0.6 = 26.8 W orbit average, which is below the original 28 W, never mind the current 30 W. The test threshold was not derived from the requirement. TC-06 measured 75.1 W and "passed", yet 75.1 W converts to 27.9 W, short of both values. Had the criterion been written from the statement, it would have read about 30 / (0.62 × 0.6) = 80.6 W peak, and the shortfall would have been visible at the first test. The change impact analysis guide follows the same finding through the change from 28 W to 30 W.
The lesson generalizes: a pass criterion should be traceable to the requirement's value by arithmetic someone can check, and the arithmetic belongs in the rationale or the verification plan, not in an engineer's memory.
Handling TBD and TBR values
Early in a project some values are not known yet. Leaving the requirement out hides the gap; inventing a number hides the uncertainty. The usual practice is to write the requirement with a placeholder and track the placeholder as an open item.
- TBD (to be determined): no value yet. "The thermal design shall keep the battery cell temperature at or above TBD °C while charging."
- TBR (to be reviewed, sometimes "to be resolved"): a best current value that is not confirmed. "…within 60 seconds" with 60 marked TBR.
Prefer TBR with an estimate over a bare TBD wherever there is any basis for a number: designers can work to an estimate, and a value that later moves is a change, which the traceability will follow. Each open item needs three things, or it is not being managed:
- An owner, the person who will close it.
- A due date or milestone, normally before the design decisions that depend on it.
- A closure plan: the analysis, test or decision that will set the value.
The EO-1 specification has three open items. 3.5 Battery Thermal Control is a TBD owned by the Thermal Engineer and already overdue. 2.4 Target Slew ("through 30 degrees within 60 seconds") is a TBR owned by the ADCS Lead, and 5.3 Downlink Link Margin ("at least 3 dB link margin at 10 degrees elevation") is a TBR owned by the Comms Lead; both carry working values that the designs use while the analyses finish.
Count the open items at each milestone and expect the count to fall. A requirements baseline with many open TBDs is a baseline in name only. The review criteria in the NASA Systems Engineering Handbook ask, from the system requirements review on, that open TBD and TBR items be identified with a plan and schedule for closing them. The tracking belongs in an attribute or a register, not only in the text: a "TBD" typed into a sentence has no owner and no date, and nothing reminds anyone to close it.
Requirement types
Classifying requirements helps reviewers ask the right questions and helps the set stay complete. The categories below are the common ones; ISO/IEC/IEEE 29148 and the INCOSE guide describe similar sets, and many projects add their own.
| Type | What it states | EO-1 example | Watch for |
|---|---|---|---|
| Functional | What the system must do | 4.3 Fault Detection: "The C&DH shall enter safe mode within 10 seconds of undervoltage detection." | A function with no performance attached; most functional requirements need a "how well" too, here "within 10 seconds" |
| Performance | How well a function is done: quantity, rate, accuracy, time | 2.1 Pointing Accuracy: "The ADCS shall point the payload boresight within 0.1 degrees of the commanded target." | Missing conditions (which mode, which life stage) and missing limit direction |
| Interface | What crosses a boundary with another system or element, and its characteristics | 5.2 UHF Command Uplink: "The UHF transceiver shall receive ground commands at 9.6 kbps." The full definition lives in the interface control document. | Requirements that restate the ICD instead of pointing to it, so the two drift apart |
| Constraint | A limit on the design or on how the system is built, imposed from outside | 4.4 Downlink Encryption: "The C&DH shall encrypt each downlink frame with 256-bit keys." Its rationale: the customer contract requires encrypted imagery in transit, so the requirement comes from outside the project, not from a trade inside it. | Design choices written as constraints when nobody outside imposed them |
| Environmental, reliability, safety | Conditions to survive and dependability to achieve | 1.7 Mission Lifetime: "The spacecraft shall operate in orbit for at least 730 days." | Values without the probability or confidence they are claimed at |
The line between functional and performance requirements is often drawn inside one sentence: many requirements state a function with its performance, as 4.3 does. That is fine as long as the sentence still holds one obligation. Interface requirements are covered in more depth in the interface control document guide, and the functions behind functional requirements in the functional analysis guide.
Worked example: reviewing the EO-1 specification

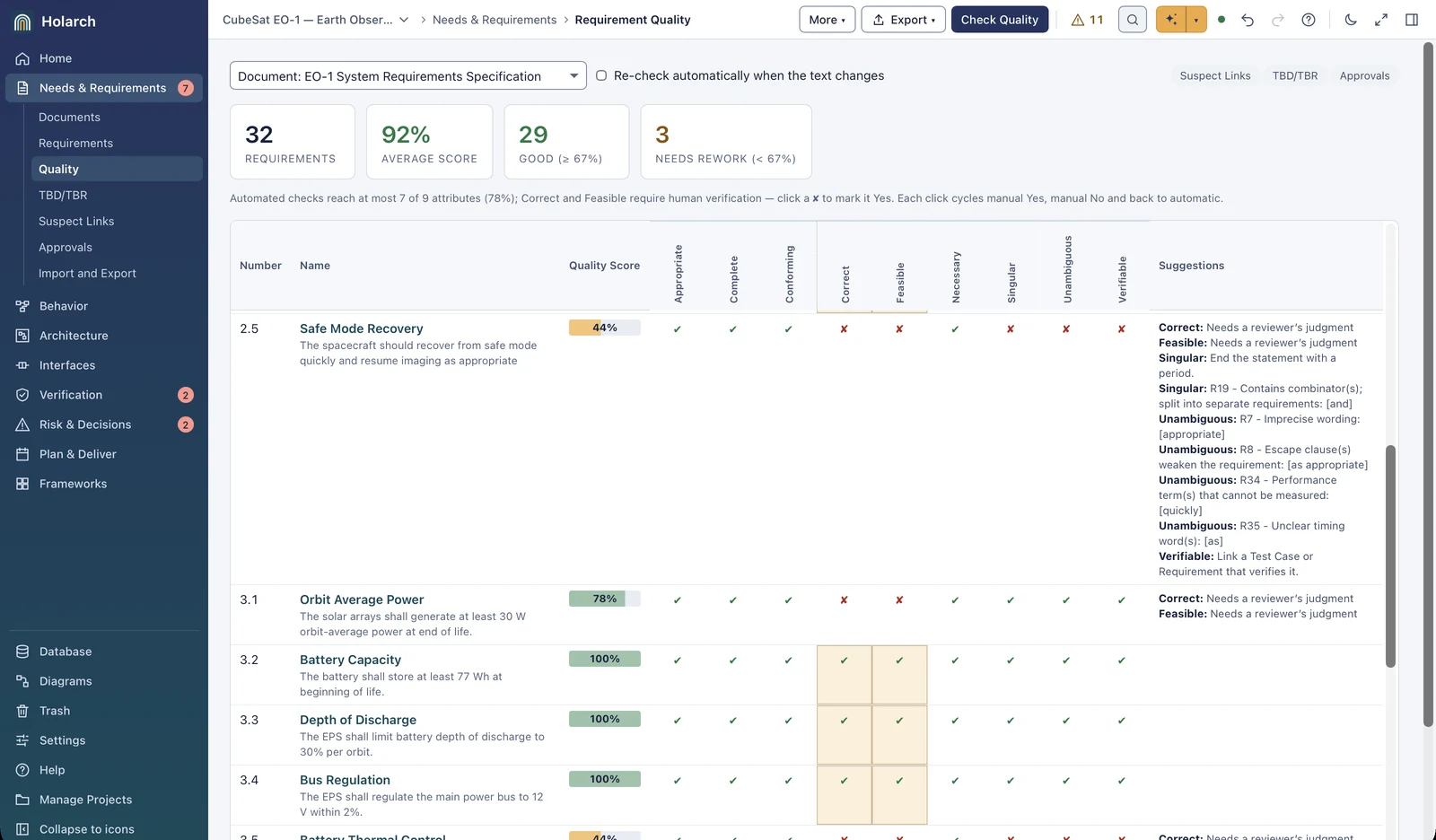

A review of SRS-001 against the checklist splits the 32 requirements into three groups. Most pass. A few have small findings worth a sentence each. Three need rewriting.
An automatic check of the same specification agrees with the review: 29 of 32 requirements score as good, and the three weak ones need rework. The findings for 2.5 list each broken rule by name and number, which is what an author needs to fix it. The check also marks what it cannot decide: on 3.1, correctness and feasibility wait for a reviewer because the text changed after the last review.
Small findings
- 1.6.2 Off-Nadir Imaging, "up to 25 degrees off nadir": "up to" reads as a maximum, but the intent is a capability the spacecraft must have at any angle from 0 to 25 degrees. A wrong reading would let a design that only images at nadir comply.
- 1.6.1 Ground Track Repeat, "its ground track": a pronoun with only one possible referent, so the finding is minor. The "every" in the same sentence is a false positive of a universal-qualifier rule.
- 1.5 Daily Collection Volume has a method (analysis) and success criteria ("Simulated daily volume of at least 3.2 GB over a 30-day plan") but no linked analysis yet. The wording is fine; the verification is not done.

- 3.1 Orbit Average Power is well written, but its text changed after approval, so its correctness and feasibility need a reviewer's judgment again. Feasibility is the real question: the arrays as designed give about 28 W orbit average.
Three rewrites
2.5 Safe Mode Recovery. "The spacecraft should recover from safe mode quickly and resume imaging as appropriate" breaks at least six rules: "should" instead of "shall", two obligations joined by "and", "quickly" with no value, the escape clause "as appropriate", no closing period, and no verification. The rewrite keeps the one outcome that matters to the customer and gives it a value:
The spacecraft shall resume imaging within 6 hours of a safe mode entry.
The rationale should say where 6 hours comes from (N1 asks for same-day crop stress alerts, and 6.2 allows 6 hours from downlink to delivery). If the steps of the recovery matter on their own, such as re-acquiring Sun pointing or reporting the cause, each becomes its own requirement. Method: test, by fault injection on the flatsat; success criterion: imaging resumes within 6 hours in each injected safe mode entry.
3.5 Battery Thermal Control. "The thermal design shall keep the battery warm enough (TBD)." has a vague term, a TBD in the text and a bracket. The fix separates the obligation, the open value and the reason:
The thermal design shall keep the battery cell temperature at or above 0 °C while charging.
The 0 °C is illustrative: lithium-ion cells are commonly not charged below freezing, but the real limit comes from the cell data sheet and the thermal analysis. Until that analysis sets it, the value is a TBR owned by the Thermal Engineer, with a due date before the thermal design review. The rewrite also exposes a gap the original hid: there is no requirement for the discharge temperature range, which needs its own statement.
6.4 Operator Interface. "The operator interface shall be user friendly and/or easy to use." has two subjective terms and an "and/or". Usability can be specified, but only through observable tasks:
The operator interface shall let a trained operator book a ground station contact in no more than 5 minutes.
The task and the time are illustrative. A real set would list the few tasks that matter (book a contact, upload a target list, read the latest health telemetry), each with a time and an error limit, measured in a demonstration with operators who completed the training.
Common mistakes
| Mistake | What goes wrong | Better |
|---|---|---|
| Writing design solutions as requirements | The design is fixed before the trade is made, and a better option is ruled out without anyone deciding to. | State the need ("keep the cells at or above 0 °C while charging") and let the level below choose the heater. |
| Copying stakeholder language straight into requirements | "Fresh imagery twice a week" is a need; it is not verifiable as written. | Keep the need, and write a requirement with a value and a condition that satisfies it (1.6 within 72 hours). |
| Several requirements in one paragraph | One identifier carries several obligations, which share one status, one test and one fate. | One requirement per item, one "shall" per statement. |
| Values without conditions | "30 W" at beginning of life and at end of life are different designs. | State mode, life stage, environment and averaging. |
| No rationale | Nobody can judge a later change, and the requirement survives long after its reason has gone. | Write the reason and the numbers behind the value. |
| Test thresholds not derived from the requirement | A test passes while the requirement is not met (TC-06 at 72 W peak against 28 W orbit average). | Derive the success criterion from the statement by arithmetic, and record it. |
| TBD typed into the text and forgotten | The open value has no owner or date and reaches the baseline. | Track each TBD and TBR with an owner, a due date and a closure plan. |
| Gold plating | Requirements nobody asked for consume design and test effort. | Check each top-level requirement traces to a need or a source. |
| Over-reliance on automatic checks | A clean word check is taken for a correct requirement. | Use tools for the mechanical rules; a person judges correct, feasible and necessary. |
Try it in Holarch
In an LML project, each requirement is an entity of class Requirement with the attributes described above: Rationale, Status, Priority, Criticality, Owner, Source, Verification Method, Verification Level, Success Criteria and the TBD/TBR fields.
- Create the demo with Manage Projects → Project Files ▾ → New Demo Project. Its specification holds the three weak requirements and the open TBD/TBR items used in this guide.
- Open Needs & Requirements → Quality, choose the document in the scope list and click Check Quality. Each requirement is scored on the nine characteristics, and the suggestions name the rule numbers from the INCOSE guide that a word list or pattern can check. Correct and Feasible need a reviewer: click the mark to record the decision.
- Rewrite 2.5 as above and run the check again. The combinator, escape clause and vague-term findings disappear.

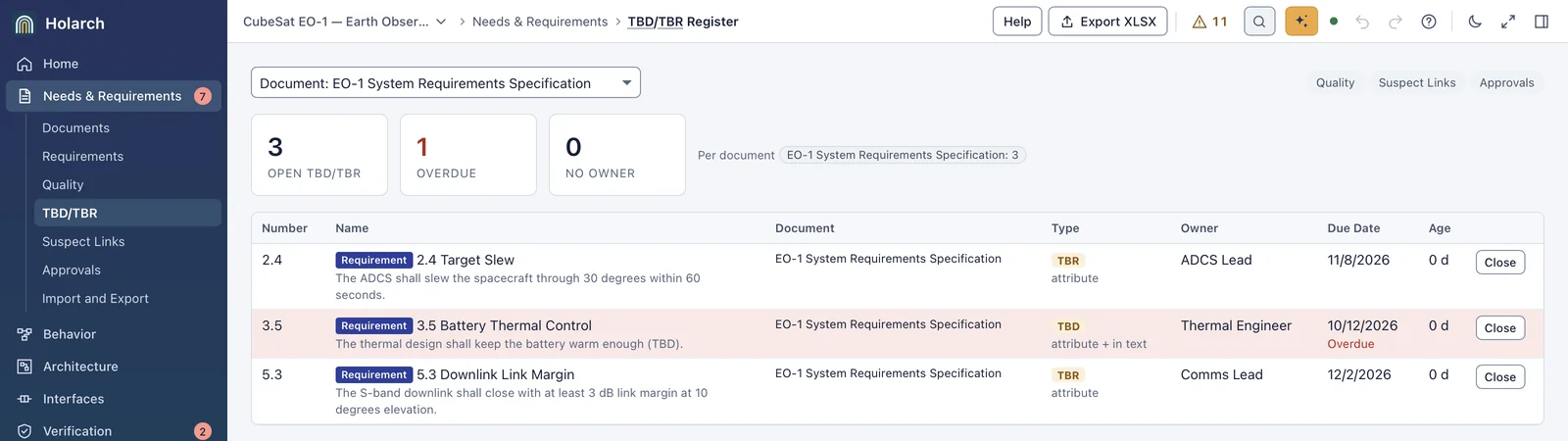

- Open Needs & Requirements → TBD/TBR to see the open items with owners and due dates, and Close one once its value is settled.
- For a second opinion on the characteristics a rule cannot decide, use ✦ AI ▾ → AI Requirement Check; every verdict and rewrite is shown for review before anything changes.
The full reference is in Requirement Quality and the TBD/TBR Register docs.
Download the checklist
The requirement quality checklist with EO-1 before-and-after examples (CSV) holds the checklist rules with their review questions and examples, for use in a review or as a starting point for a project's own writing rules. The same file is offered by the traceability guide.
Questions about writing requirements
Shall, must or will?
Any convention works if the specification defines it and keeps to it. The most widespread one uses "shall" for binding requirements, "will" for facts and intentions about things outside the system, and "should" for goals that are not verified. Some government style guides prefer "must" for plain-language reasons. Mixing them inside one specification is the real problem.
How many requirements should a system have?
There is no right number. A small spacecraft may have a few dozen system requirements and a few hundred below them; a large program has thousands. More useful questions are whether every requirement traces to a need or a parent, and whether every need has requirements under it.
Are user stories requirements?
A user story records a need and its purpose in the user's terms. It plays the role of a stakeholder need, and its acceptance criteria are close to verification criteria. For a system that is built, integrated and verified as hardware and software together, the stories still need to be turned into requirements that can be allocated and tested.
Can a tool check requirement quality?
A tool can check the mechanical rules reliably: modal verbs, combinators, vague words, escape clauses, pronouns, missing links. It cannot know whether 30 W is the right value or whether the arrays can deliver it. Use the automatic check to clear the mechanical findings before a review, so the reviewers spend their time on correctness and feasibility.
Where to go next
- Requirements traceability and change impact: link these requirements to needs, design and tests, and follow a change.
- Functional analysis: turn the requirements into functions and allocate them.
- Requirements verification matrix: plan the verification method for each requirement and record the results.
- Needs and requirements in Holarch: documents, quality checks, baselines and traceability in one model.
